Three teams shortlisted for £5.7bn White Horse Reservoir
Reporting by Tunneling JournalRead the original at tunnellingjournal.com
Executive Summary

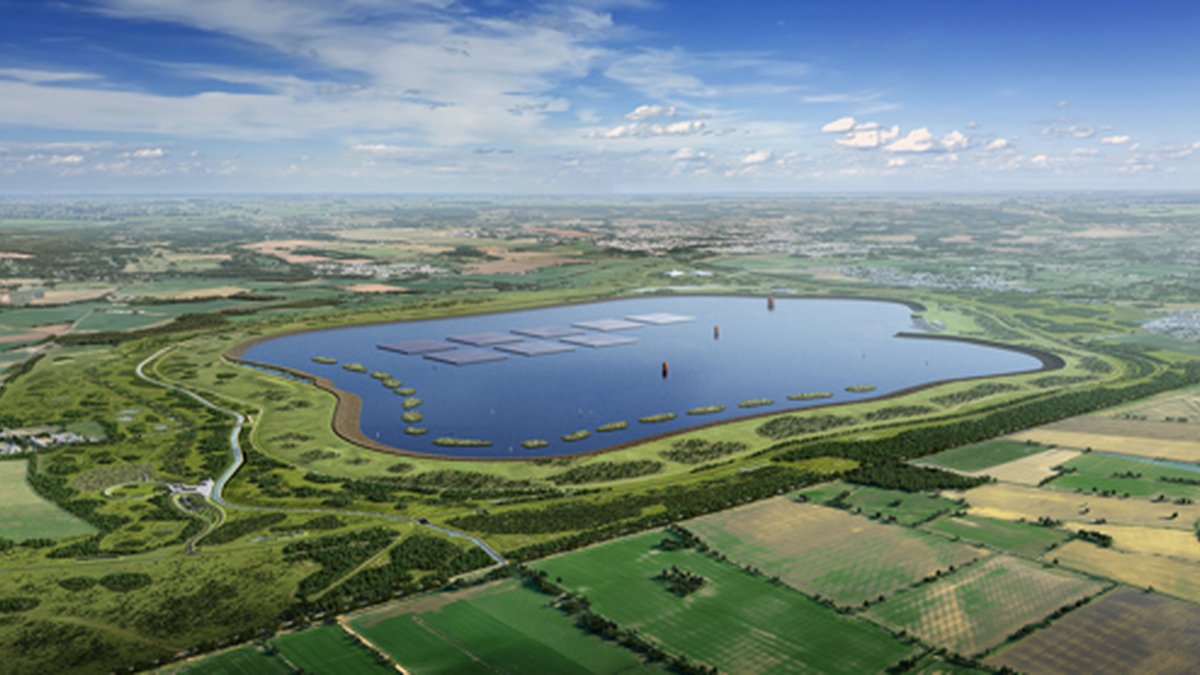

Thames Water has invited three international joint ventures to bid for the £5.7 billion main works contract for its proposed White Horse Reservoir near Abingdon, Oxfordshire. The shortlisted teams are WFH JV (Webuild, Hyundai Engineering & Construction, and FCC Construcción), BMV+ (Bouygues Travaux Publics, J Murphy & Sons, and VolkerFitzpatrick), and BBV (Balfour Beatty Civil Engineering and VINCI Construction Grands Projets). The contract involves designing, building, testing, and commissioning a 150 billion-litre reservoir intended to secure water supplies for approximately 15 million people across the Thames Water, Affinity Water, and Southern Water regions.
The project includes a substantial tunnelling package connecting the reservoir with the River Thames. A main 3.5km tunnel would run between a new intake/outfall structure near Culham and the reservoir pumping station, designed as a segmentally lined tunnel with a 6.6m outer diameter and 6m internal diameter. The eastern end of this tunnel would receive an additional cast in-situ secondary lining to reduce the finished internal diameter to 5.5m. Excavation methodology involves Tunnel Boring Machines (TBMs) operating on a 24-hour, seven-day basis with clay being reused for reservoir embankments.
A second, approximately 450m-long reservoir tunnel connects the pumping station to the main tower, excavated conventionally through clay using sprayed concrete lining instead of a TBM. This tunnel is designed with a 7.5m outer diameter and 7.1m internal diameter at the primary stage, with subsequent lining reducing the finished internal diameter to 5.8m. This reservoir tunnel will remain dry and accommodate two pipelines for inflow and outflow, providing access for maintenance, power, and communications. The pumping station is proposed as three interlocked 50m-diameter cells formed by diaphragm walls. Thames Water plans to install pipework by welding sections in the basement before pushing pipelines into the tunnel using hydraulic jacks.
The project is estimated to take about a decade for construction and two winters for filling, with water anticipated to be available from 2040. The delivery strategy involves an independent infrastructure provider using a regulated model similar to the Thames Tideway Tunnel. The detailed design and construction methods are based on the current Gate 3 design but may evolve during the procurement process.
Facts Only
* Thames Water invited three international joint ventures to tender for the £5.7bn main works contract for the White Horse Reservoir near Abingdon, Oxfordshire.
* The shortlisted teams are WFH JV, BMV+, and BBV.
* The contractor will design, build, test, and commission a 150 billion-litre reservoir.
* The reservoir is expected to secure water supplies for around 15 million people across Thames Water, Affinity Water, and Southern Water regions.
* A main tunnel connecting the reservoir with the River Thames is planned, approximately 3.5km long.
* The primary river tunnel design specifies a segmentally lined tunnel with a 6.6m outer diameter and 6m internal diameter.
* A secondary lining will reduce the finished internal diameter of the eastern end of the river tunnel to 5.5m.
* Excavation of the river tunnel would use TBMs, and excavated clay would be reused in reservoir embankments.
* A second reservoir tunnel connecting the pumping station to the main tower is planned as a conventional excavation with sprayed concrete lining.
* The reservoir tunnel is designed to be dry, accommodating two pipelines for inflow and outflow.
* The pumping station is proposed as three interlocked 50m-diameter cells formed by 1.2m-thick diaphragm walls.
* Construction is expected to take around a decade, with water availability planned from 2040.
Full Take
The project presents a large-scale infrastructure challenge defined by the complexity of integrating massive civil engineering—specifically tunnelling and reservoir construction—with complex environmental and regulatory requirements across multiple water authorities. The focus on specific tunneling methods reveals a tension between maximizing efficiency (using TBMs for the river link) and managing site logistics (conventional excavation for the internal tunnel). The material reuse strategy, where excavated clay is reused in embankments, suggests an attempt to manage waste streams, but the reliance on sprayed concrete lining in one section versus precast segments in another introduces variations in risk profiles for long-term structural integrity.
A crucial pattern emerges around temporal pacing and scope creep: the timeline allocates significant time for design evolution during procurement, suggesting that methodologies are fluid rather than fixed. The separation between the wet river tunnel (carrying water) and the dry reservoir tunnel underscores a fundamental engineering trade-off: managing hydrological flow versus providing necessary access and operational pathways. The fact that the final tunnel dimensions are explicitly stated as "based on Thames Water’s current published Gate 3 design" highlights a point of potential vulnerability where future regulatory or environmental shifts could necessitate significant rework, demonstrating a need for robust contingency planning beyond the immediate scope.
The implications touch upon governance: delivering this through an independent infrastructure provider echoes prior large-scale water projects. This model necessitates a high degree of trust between multiple governing bodies and contractors to maintain cohesion during a decade-long development. The inherent complexity suggests that success will not solely depend on the engineering execution, but heavily on the resilience of the multi-party contractual relationship throughout the procurement phase. What assumptions underpin the expectation that the agreed-upon design standards will hold across the entire project lifecycle, regardless of subsequent planning adjustments?
